The Second Niger Bridge, a monumental infrastructure project aimed at easing transportation between the eastern and western parts of Nigeria, has been a topic of discussion among stakeholders, residents, and observers. While many assume that the project is fully completed, the reality is more nuanced. Below, we delve into the current status of the bridge, its phases, and what remains to be done.
The Current Status of the Second Niger Bridge
As of today, the Second Niger Bridge project is not entirely complete. However, significant progress has been made, particularly in Phase 1, which includes the main bridge structure and its immediate connecting infrastructure. Here’s a detailed breakdown:

Phase 1: Completion and Inauguration

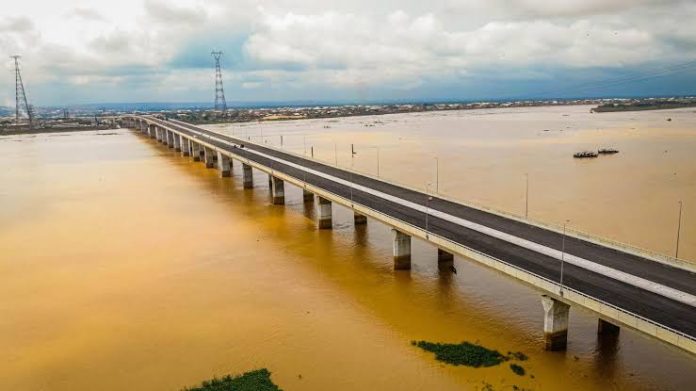

Phase 1 of the project encompasses the main bridge itself, which spans 1.6 kilometers, along with approximately 10.3 kilometers of approach roads connecting Asaba and Onitsha. Additionally, this phase includes two secondary bridges—at Amakon Village Road and Atani Road—and a cloverleaf interchange at Onitsha-Owerri Road.
According to the Nigeria Sovereign Investment Authority (NSIA), Phase 1 reached 100% completion by the fourth quarter of 2024. The Federal Government of Nigeria officially took over the project on December 12, 2023, marking a significant milestone.
The bridge was inaugurated for public use on May 23, 2023, in a ceremony attended by several dignitaries, including:
- President Muhammadu Buhari
- Governor Ifeanyi Okowa of Delta State
- Governor Chukwuebuka Eze of Anambra State
- High-ranking officials from the Federal Ministry of Works and Housing
- Representatives from the NSIA and contractors involved in the project

A temporary 2.4-kilometer access road from the Asaba end to the Benin-Asaba dual carriageway was also opened to allow immediate operation of the bridge. This means that the main bridge structure and its initial connecting infrastructure are now finished and operational.
Phase 2: Ongoing Work and Challenges
While Phase 1 is complete, Phase 2 of the project, which involves additional approach roads, remains under construction. These roads are crucial for the bridge to be fully integrated into the broader highway network, reducing reliance on temporary access routes.
Approach Road 2A
- Contractor: Julius Berger Nigeria Plc
- Commencement Date: March 8, 2022
- Estimated Duration: 37 months
- Completion Timeline: Mid-2025 (at the earliest)
Approach Road 2A consists of 17.5 kilometers of highway linking Benin to Asaba. Given the estimated timeline, it may not be completed until mid-2025, depending on the pace of construction.
Approach Road 2B
- Contractor: Reynolds Construction Company
- Commencement Date: June 25, 2020
- Estimated Duration: 48 months
- Completion Timeline: Mid-2024 or beyond
Approach Road 2B involves another 17.5 kilometers of highway linking Onitsha to Enugu. Although the project started earlier than Approach Road 2A, updates on its exact status are less clear, suggesting potential delays.
Why Phase 2 Matters
The completion of Phase 2 is essential for the full functionality of the Second Niger Bridge. Without these additional approach roads, traffic will continue to rely on temporary access routes, which may not adequately handle the expected volume of vehicles. Fully integrating the bridge into the national highway network will significantly enhance connectivity and economic activity in the region.

Conclusion
In summary, while the main structure of the Second Niger Bridge and its immediate connecting infrastructure are operational, the project as a whole is not yet complete. Phase 2, which involves critical approach roads, is still underway and is expected to take some time before reaching full completion. The successful conclusion of all phases will mark a major achievement in Nigeria’s infrastructure development, facilitating smoother transportation and boosting economic growth across the country.
Stay tuned for further updates as work progresses on this vital infrastructure project!
